The Capital Line

A new urban pathway through the heart of Downtown Columbus

About the Capital Line

The Capital Line is an urban pathway woven through the heart of Downtown Columbus. This two-mile journey, exclusive to bike and pedestrian traffic, offers an intentional route to some of the city’s most vibrant attractions, connecting amenities, greenspaces, job centers, and residential neighborhoods within Downtown Columbus, catalyzing new economic investment along the route and enhancing the Downtown experience to put people first.

 The Capital Line will stand as a testament to the city’s commitment to fostering a vibrant, accessible, and interconnected Downtown. This innovative urban pathway will not only bridge the geographical gaps between diverse neighborhoods but will also act as a catalyst for cultural enrichment, social cohesion, and economic revitalization within the heart of the city that will benefit everyone in the Columbus Community.

The Future Capital Line

Project Progress Photos

Parking on Gay Street

To help offset the loss of on-street parking and support continued access to Gay Street businesses, the City is helping provide convenient, affordable parking for customers during construction at the Fourth and Elm garage (78 N. Fourth Street), just a five-minute walk to the Gay and High intersection.  

Fourth and Elm Garage 
78 N. Fourth Street  
$1 per hour (max 3 hours)  
With a validation from a Gay Street Business 

Are you a Gay Street Business wondering how to request validations? Complete the form in the button below to be included in the next distribution.

Capital Line Office Hours

Have a question about construction? Want to talk through a concern specific to your business or property? We’re introducing Capital Line Office Hours to make it easier to connect with the project team in person.

Beginning Friday, July 17, a member of the Capital Line project team will be at Brioso Coffee (53 N. High Street) every Wednesday and Friday from 9 – 10 a.m.

Stop by to:

  • Ask questions about upcoming construction
  • Review access, deliveries or construction impacts
  • Walk through issues on-site if needed

While we’re always available by phone or email, sometimes it’s easier to have a conversation face-to-face or step outside together to look at a specific concern. No appointment is necessary, just stop in during office hours.

  • Brioso Coffee (53 N. High Street)
  • Wednesdays & Fridays, 9-10 a.m.

For your convenience, the location of office hours may change as construction progresses, so we’re always close to the active work area.

Gay Street Awaits!

Let us help you find your way!

Businesses on Gay Street are open and remain accessible during construction! From local goods to artisan products and fine dining to quick bites, there is something for everyone on Gay Street. Chat with us to find the perfect destination for you.

Gay Street Construction Schedule

BLOCK

Utility Work

April – October 2026

Pre-Block to Block



Block to Block

August – November 2027

Block Reopens

Front to High



April – June 2026



June – July 2026



August – December 2026



December 2026



High to Pearl



June – October 2026



November 2026



November 2026 – March 2027



March 2027



Pearl to Third



August – October 2026



February – March 2027



March – July 2027



July 2027



Third to Fourth



July – October 2026



June – July 2027



July – November 2027



November 2027





What to Expect During Block-to-Block Construction

Over the past several months, crews have been installing the underground infrastructure that will support the new streetscape. While this utility work will continue through October, we’re now preparing for the next major phase of construction: block-to-block reconstruction of Gay Street.

Approximately 4–6 weeks before block-to-block construction begins, crews will begin preparing your block so they can move efficiently once the roadway closes.

6 weeks before block-to-block construction

Before any work begins adjacent to buildings, businesses with outdoor patios will need to temporarily close and clear those spaces.

  • Messer will notify businesses with patios 1-2 weeks prior to the work beginning to remove and store patio furniture and personal items.

  • Messer will also remove and safely store patio fencing, reinstalling after the block-to-block construction is complete.

Patios will remain closed until construction on that block is complete, and it is safe to reopen.

We understand patios are an important part of many businesses, particularly during the warmer months, and crews will work to restore them as quickly as possible.

6 weeks before block-to-block construction

Following patio closures, crews will begin work immediately adjacent to buildings while the street remains open to traffic.

Work will extend approximately 6-10 feet from the building face, allowing crews to complete the new sidewalk before the roadway reconstruction begins.

  • During this phase, you can expect:

    • Excavation along building fronts.

    • Clearly marked pedestrian pathways protected by barricade.

    • Temporary plywood and asphalt ramps

    • Intermittent increases in construction noise during normal working hours

Business entrances will remain accessible throughout this work. However, crews will need to work directly in front of individual doorways for 1–2 days to pour new concrete. They will use quick-curing concrete and provide temporary ramps to restore access as quickly as possible. Pavers will be installed later during block-to-block construction (Step 3 below).

Messer Construction will coordinate individually with the affected business or property owner to schedule the work at the least disruptive time whenever possible.

When this phase is complete, the newly poured concrete adjacent to buildings will become the primary pedestrian route during the next stage of construction.

View block-to-block prep from Front to High: Phase 2A, Phase 2

Road closed to vehicular traffic. Pedestrian access is maintained.

Once preparation work is complete, crews will begin full block-to-block reconstruction.

During this phase:

  • The active block will be closed to vehicular traffic. Loading zones will be identified.

  • Pedestrian access to buildings will be maintained.

  • Customers, employees, residents and visitors will use the newly constructed walkway adjacent to the building face for access.

  • Construction fencing will safely separate pedestrians from the active work zone.

  • Ramps and bridges will be used as needed to create accessible pathways through and around active construction.

As work moves east, the major intersections at High Street and Third Street will be reconstructed while work continues on the blocks on either side. Construction will occur one corner at a time, beginning at the southwest corner and moving clockwise around the intersection. Each corner is expected to take approximately two weeks, for a total construction duration of about two to three months per intersection.

Work at the alley intersections will be handled more flexibly to accommodate the many ways these alleys serve Gay Street businesses, including deliveries, loading, and access.

After utility work is completed in October 2026, the areas of Gay Street outside the active construction block will reopen to two-way traffic.

As construction progresses east, completed sections of Gay Street will reopen while work continues on the next block.

To support access during construction:

  • Temporary loading zones will be available for deliveries, customer pickup and drop-off, rideshare services and quick stops.

  • Loading zones should generally be used for 15 minutes or less to keep them available for everyone.

  • Long-term on-street parking will not be available

  • The Fourth & Elm Garage validation program will continue for participating businesses.



Happening Now: Front to High Block

Block-to-Block: August 3, 2026 - December 16, 2026

Road closed to vehicular traffic during Block-to-Block phase. Pedestrian access is maintained.

  • Loading zones are available for 15-minute max stops.

  • Pedestrian access to buildings will be maintained.

  • Customers, employees, residents and visitors will use the newly constructed walkway adjacent to the building face for access.

  • Construction fencing will safely separate pedestrians from the active work zone.

  • Ramps and bridges will be used as needed to create accessible pathways through and around active construction.

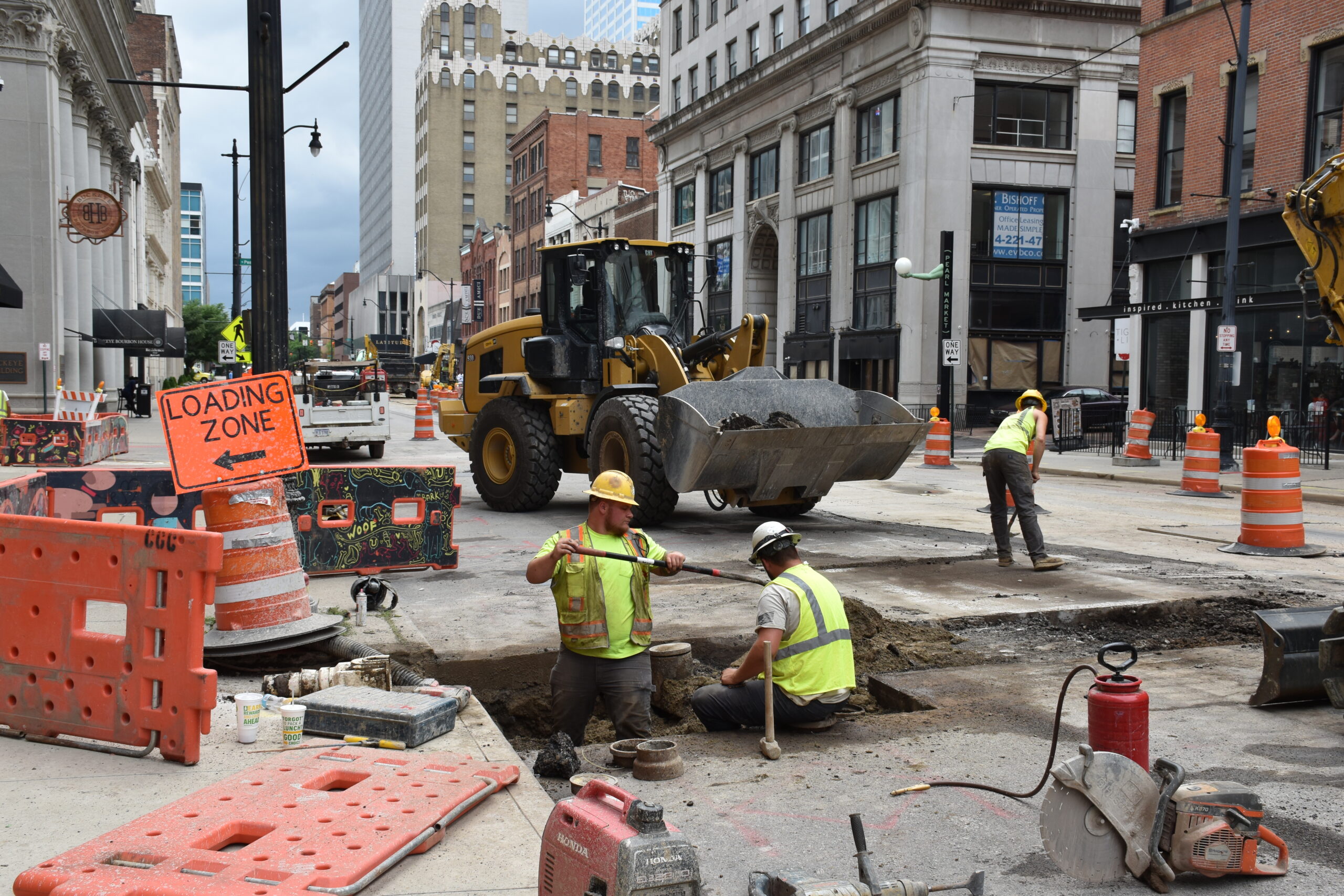

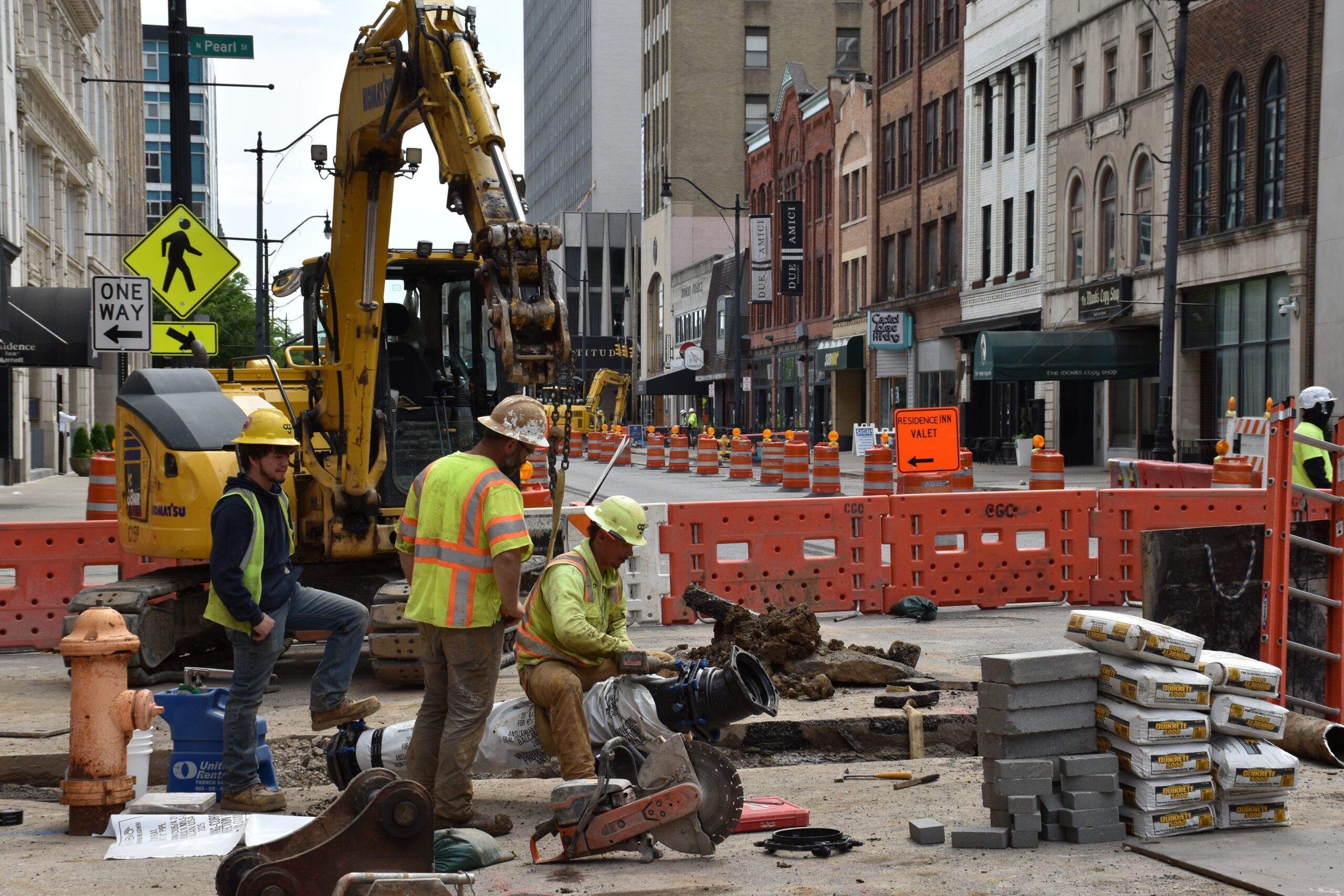

Example of current building front work (Front–High)
Barricades will guide pedestrians safely through work

Block to Block prep from Front to High

Block-to-Block from Front to High

Latest on the Line

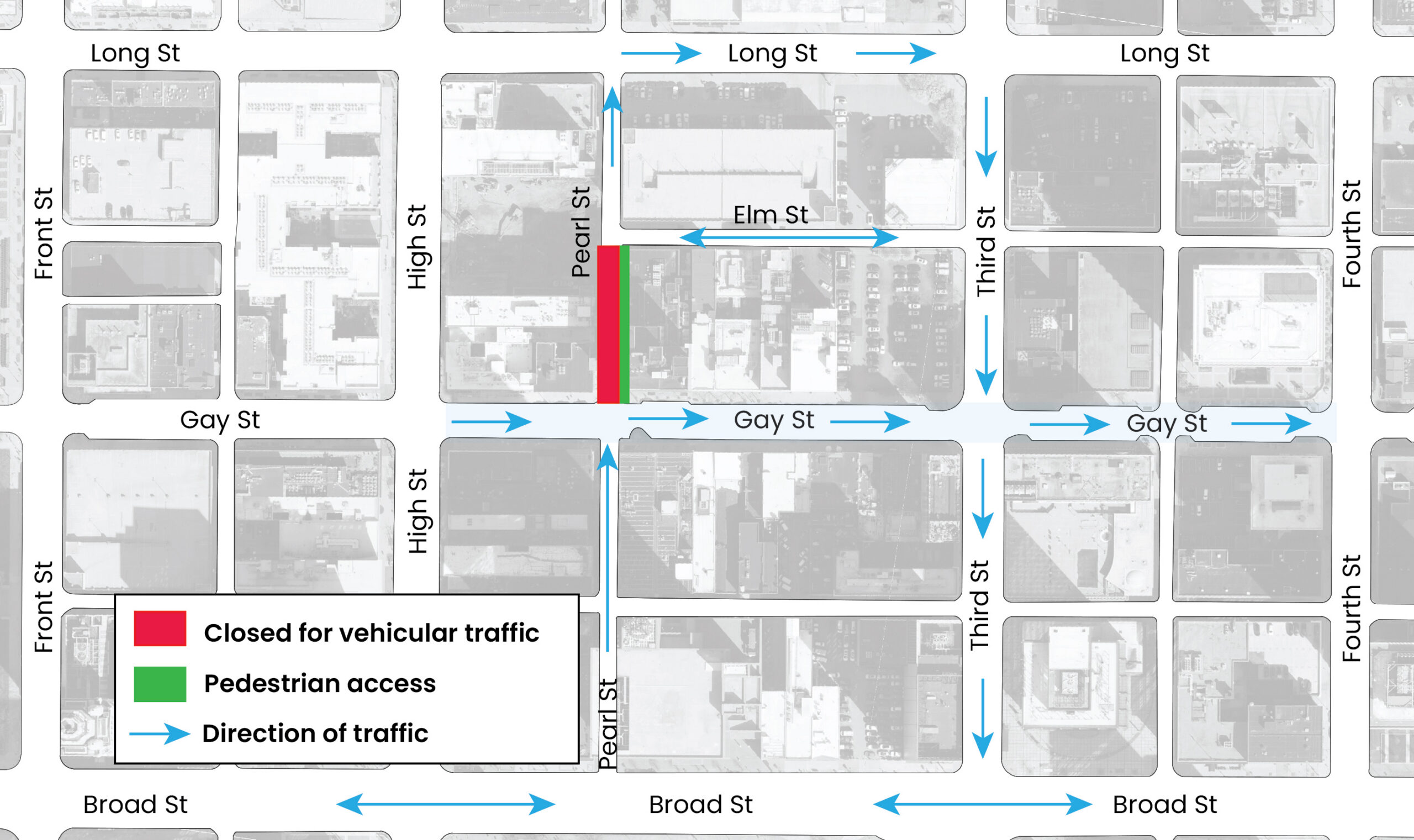

High to Pearl Planned Waterline Shutdown week of Aug 24

Gay Street Construction Update

What you need to know now:

UPDATE WHEN WHAT YOU NEED TO KNOW
High to Pearl Waterline Shutdown Thursday, Aug. 27

Affected buildings and businesses will be contacted directly by the City of Columbus 48 hours before the shutdown.

Pearl to Third Waterline Shutdown Thursday, Sept. 3

Affected buildings and businesses will be contacted directly by the City of Columbus 48 hours before the shutdown.

Front to High Construction

Through December

Block-to-block construction began Monday, Aug. 3. The block is closed to vehicular traffic, but pedestrian access to buildings will be maintained at all times. Learn more about this work on our website.

Capital Line Office Hours

Wednesdays & Fridays,

9–10 a.m.

Stop by Brioso Coffee with questions about construction. No appointment needed.
Weekly Street Sweeping Fridays

Street sweeping will continue weekly from Front Street to Fourth Street to help keep the area tidy after construction work.



Work in Your Block

A two-week look ahead at what’s happening in your block



Front & Gay Intersection

Work on manholes, pedestrian ramps and pavers was completed July 31.



Front Street to High Street

Currently closed to vehicular traffic through December 2026

A new sidewalk for pedestrian access on the south side of Gay from Wall to High is completed.

The north sidewalk has been excavated, and new concrete will be poured at business entrances on Friday, Aug. 21, pending weather.  Messer will reach out to coordinate work in doorways for individual businesses from Front to High.



LeVeque Garage parkers will continue to follow the Gay Street exits to Wall Street and out to Broad Street or Lynn Alley. Concrete has been poured at two of the exit lanes.

The final lane will be poured in the week of August 24, with two exit lanes staying open.

Pedestrian access will be diverted from the building face to the roadway along a designated route.

The concrete base will not be final grade, so exits will be plated with metal plates and compacted with stone.



High Street & Gay Street Intersection

Temporary traffic poles are being installed at the intersection. These traffic poles will not be part of the finished condition.

Pedestrians can cross High Street on the south side of Gay Street.

  • Start Date: Friday, July 31

  • Duration: 3-4 weeks

  • Location: Northeast corner of the intersection and southwest side of High Street.

  • Impacts:

    • Intermittent excavation

    • Periods of increased noise and dust during normal work hours



High Street to Pearl Street

A planned water shutdown will take place on Thursday, August 27 over the course of a predetermined, 4-hour window.

Impacted businesses will be contacted directly by the City of Columbus at least 48 hours prior. Affected properties will also receive a door notice from Complete General Construction with additional details.

  • Location: South side of Gay Street, from High Street to Third Street

  • Impacts: Water service will be unavailable during the shutdown. Sinks, toilets, and water-dependent appliances will not be operational until service is restored.



Pearl Street to Third Street

A planned water shutdown will take place on September 3 over the course of a predetermined, 4-hour window.

Impacted businesses will be contacted directly by the City of Columbus at least 48 hours prior. Affected properties will also receive a door notice from Complete General Construction with additional details.

  • Location: South side of Gay Street, from Third Street to Fourth Street

  • Impacts: Water service will be unavailable during the shutdown. Sinks, toilets, and water-dependent appliances will not be operational until service is restored.



Third & Gay Street Intersection

Work at the intersection is completed as of August 14. All southbound traffic lanes on Third Street are open.

Additional work will be required in the area as the project continues, but the schedule for that work has not yet been determined. Updates will be shared once dates are confirmed.





Third Street to Fourth Street

Crews are working on the water main installation at Gay and Lazelle Street.

  • Duration: Approximately 2–3 weeks

  • Location: South side of Gay Street, at Lazelle Street

  • Impacts:

    • Through access at Lazelle is closed.

    • Intermittent hydro excavation and excavation resulting in increased noise during normal work hours.

  • Important Notes: Access to driveways will be maintained

Gay Street Construction Update: Front to High Streets Block-to-Block Construction Starting August 3

What you need to know now:

  • Work this Saturday, July 25: Spectrum crews will conduct prep work on the south side of Wall Street from 7 am – 4 pm. No loud noise will result from this work.
  • Work on the north side of Front to High along the building faces will begin early next week, July 27. Expect new pedestrian access routes. Keep reading for more details.
  • Block-to-Block construction begins Monday, August 3. The Front Street to High Street block will close to vehicular traffic, but pedestrian access to buildings will be maintained at all times. More information about this work can be found on our website.
  • Capital Line Office Hours: We heard your requests for the chance to discuss the project in person. Stop by our office hours at Brioso Coffee (53 N High Street) on Wednesdays and Fridays from 9–10 am to meet with the project team, ask questions, discuss access or deliveries, and review site-specific concerns—no appointment needed.
  • Spectrum and Lumen shutdowns: Spectrum and Lumen customers will be temporarily without service Monday, July 27 through Thursday, July 30, only from 12 am-6 am each day to transition to new service lines. Customers should have received notifications directly. No other internet services will be disrupted due to Gay Street construction. If you are not a Spectrum or Lumen customer and experience internet issues, contact your provider directly.
  • Temporary utility shutdowns for vault properties continue through mid-August. Messer is reaching out directly to affected property owners at least two weeks in advance of planned shutdowns to coordinate.
  • Street sweeping will occur weekly on Fridays starting today, July 24 from Front Street to Fourth Street. We heard your feedback about keeping the street tidy after work hours, especially over weekends.


Work in Your Block

Front & Gay Intersection

  • Intersection work on manholes, pedestrian ramps, and pavers will continue through next week.
  • Estimated Completion Date: Friday, July 31
  • Location: West side of the Front & Gay Streets intersection
  • Impacts:
    • Changes to pedestrian traffic flow
    • Intermittent hydro excavation and excavation
    • Periods of increased noise and dust during normal work hours
  • Important Notes: Alternate pedestrian routes are signed

Front Street to High Street
South side block-to-block preparation work along the building faces will conclude in the next week.
  • Estimated Completion Date: Friday, July 31
  • Location: South side of Gay Street, from Front Street to High Street. 6-12 feet from the building face.
  • Impacts:
    • Changes to pedestrian traffic flow
    • Intermittent hydro excavation and excavation
    • Periods of increased noise and dust during normal work hours
  • Important Notes:
    • Pedestrian paths will remain accessible with temporary ramps as needed.
    • For any work impacting doorways, Messer will coordinate directly with each business.
    • A temporary concrete sidewalk will be in place until the final sidewalk is installed.

North side block-to-block preparation work along the building faces will begin next week.
  • Start Date: Monday, July 27
  • Duration: 2-3 weeks
  • Location: North side of Gay Street, from Front Street to High Street. 6-12 feet from the building face.
  • Impacts:
    • Changes to pedestrian traffic flow
    • Intermittent hydro excavation and excavation
    • Periods of increased noise and dust during normal work hours
  • Important Notes:
    • Pedestrian paths will remain accessible with temporary ramps as needed.
    • For any work impacting doorways, Messer will coordinate directly with each business.
    • A temporary concrete sidewalk will be in place until the final sidewalk is installed.

LeVeque Garage parkers will continue to use the Gay Street garage exits and will follow the exit to Wall Street and out to Broad Street. Two lanes of exits will be maintained at all times throughout construction as shown in the map below. For more information, contact Metropolis.


To learn more about what will change when block to block work begins here on Monday, August 3, check out our website here.

High Street to Third Street
Waterline work in this area is ongoing.  Following a chlorination process, the final connections will be made in late August resulting in a temporary water shutdown.
  • Estimated Completion Date: Wednesday, July 29.
  • Location: South side of Gay Street, from High Street to Third Street
  • Impacts:
    • Intermittent hydro excavation and excavation resulting in increased noise during normal work hours.
    • A temporary water shutdown will occur in late August. Affected property and business owners will be contacted directly as soon as we know when the City plans to complete the work (minimum two days’ notice).

Third & Gay Street Intersection
  • Work at the intersection will be completed by Wednesday, July 29. Once completed, all traffic lanes will reopen.

Third Street to Fourth Street
Water main and duct bank installation is moving east from Lazelle to Fourth Street.
  • Dates: July 22 – August 7
  • Duration: Approximately 2–3 weeks
  • Location: South side of Gay Street, from Lazelle Street to Fourth Street
  • Impacts:  Intermittent hydro excavation and excavation resulting in increased noise during normal work hours.
  • Important Notes: Access to driveways will be maintained


Traffic, Loading & Parking

After utility work is completed in October 2026, the areas of Gay Street outside the active construction block will reopen to two-way traffic.

As construction progresses east, completed sections of Gay Street will reopen while work continues on the next block.

To support access during construction:

  • Temporary loading zones will be available for deliveries, customer pickup and drop-off, rideshare services and quick stops.

  • Loading zones should generally be used for 15 minutes or less to keep them available for everyone.

  • Long-term on-street parking will not be available

  • The Fourth & Elm Garage validation program will continue for participating businesses.




Need Immediate Assistance?

If you have an urgent construction issue or a concern that can’t wait until office hours, please don’t hesitate to contact us by phone or email. We’re happy to help or connect you with the appropriate member of the project team.

Project Updates & Business Support

Madison Cole, Capital Line Project Executive, Downtown Columbus, Inc.

760-409-7114 | [email protected]

Construction Questions & Onsite Issues

Alec Schroeder, Project Engineer

614-935-6093 | [email protected]

Jason Starr, Superintendent

740-485-1113 | [email protected]

Types of concerns they can help with quickly:

  • Dirt or materials on the building facade after excavation
  • Questions about work hours or durations in your immediate vicinity
  • Loading zone usage or related issues
  • Utility outage questions



Supporting Gay Street Businesses

We’re continuing to invest in tools that help customers find and support Gay Street businesses throughout construction.

As blocks close, construction fencing will feature Gay Street Awaits messaging, wayfinding and project renderings to help visitors navigate the corridor and get excited about the future. As work is completed, fencing will be removed as quickly as it is safe to do so, reopening portions of the street along the way.

Resources for Businesses:

Special Construction Update

What to Expect During Block-by-Block Construction

Over the past several months, crews have been installing the underground infrastructure that will support the new streetscape. While this utility work will continue through October, we’re now preparing for the next major phase of construction: block-to-block reconstruction of Gay Street.

We know many of you are planning months in advance, so below is an overview of the current construction schedule, what you can expect before work reaches your block, and how access will be maintained throughout construction.

Please note that construction schedules remain weather and field-condition dependent and may change as work progresses.



Construction Schedule

Utility Work

Ongoing through October 2026

Underground utility installation and utility transitions will continue throughout the corridor while block-by-block construction begins.

Block-by-Block Construction

Block

Current Schedule

Front Street → High Street

August – December 2026

High Street Intersection

November – December 2026

High Street → Pearl Street

November 2026 – March 2027

Pearl Street → Third Street

March – July 2027

Third Street Intersection

June – July 2027

Third Street → Fourth Street

June – November 2027

View block-by-block schedule map



What to Expect Before Construction Reaches Your Block

Approximately 4–6 weeks before block-to-block construction begins, crews will begin preparing your block so they can move efficiently once the roadway closes.

Step 1: Patio Closure

6 weeks before block-to-block construction

Before any work begins adjacent to buildings, businesses with outdoor patios will need to temporarily close and clear those spaces.

  • Messer will notify businesses with patios 1-2 weeks prior to the work beginning to remove and store patio furniture and personal items.

  • Messer will also remove and safely store patio fencing, reinstalling after the block-to-block construction is complete.

Patios will remain closed until construction on that block is complete, and it is safe to reopen.

We understand patios are an important part of many businesses, particularly during the warmer months, and crews will work to restore them as quickly as possible.

Step 2: Preparation Along Building Fronts

6 weeks before block-to-block construction

Following patio closures, crews will begin work immediately adjacent to buildings while the street remains open to traffic.

Work will extend approximately 6-10 feet from the building face, allowing crews to complete the new sidewalk before the roadway reconstruction begins.

  • During this phase, you can expect:

    • Excavation along building fronts.

    • Clearly marked pedestrian pathways protected by barricade.

    • Temporary plywood and asphalt ramps

    • Intermittent increases in construction noise during normal working hours

Business entrances will remain accessible throughout this work. However, crews will need to work directly in front of individual doorways for 1–2 days to pour new concrete. They will use quick-curing concrete and provide temporary ramps to restore access as quickly as possible. Pavers will be installed later during block-to-block construction (Step 3 below).

Messer Construction will coordinate individually with the affected business or property owner to schedule the work at the least disruptive time whenever possible.

When this phase is complete, the newly poured concrete adjacent to buildings will become the primary pedestrian route during the next stage of construction.

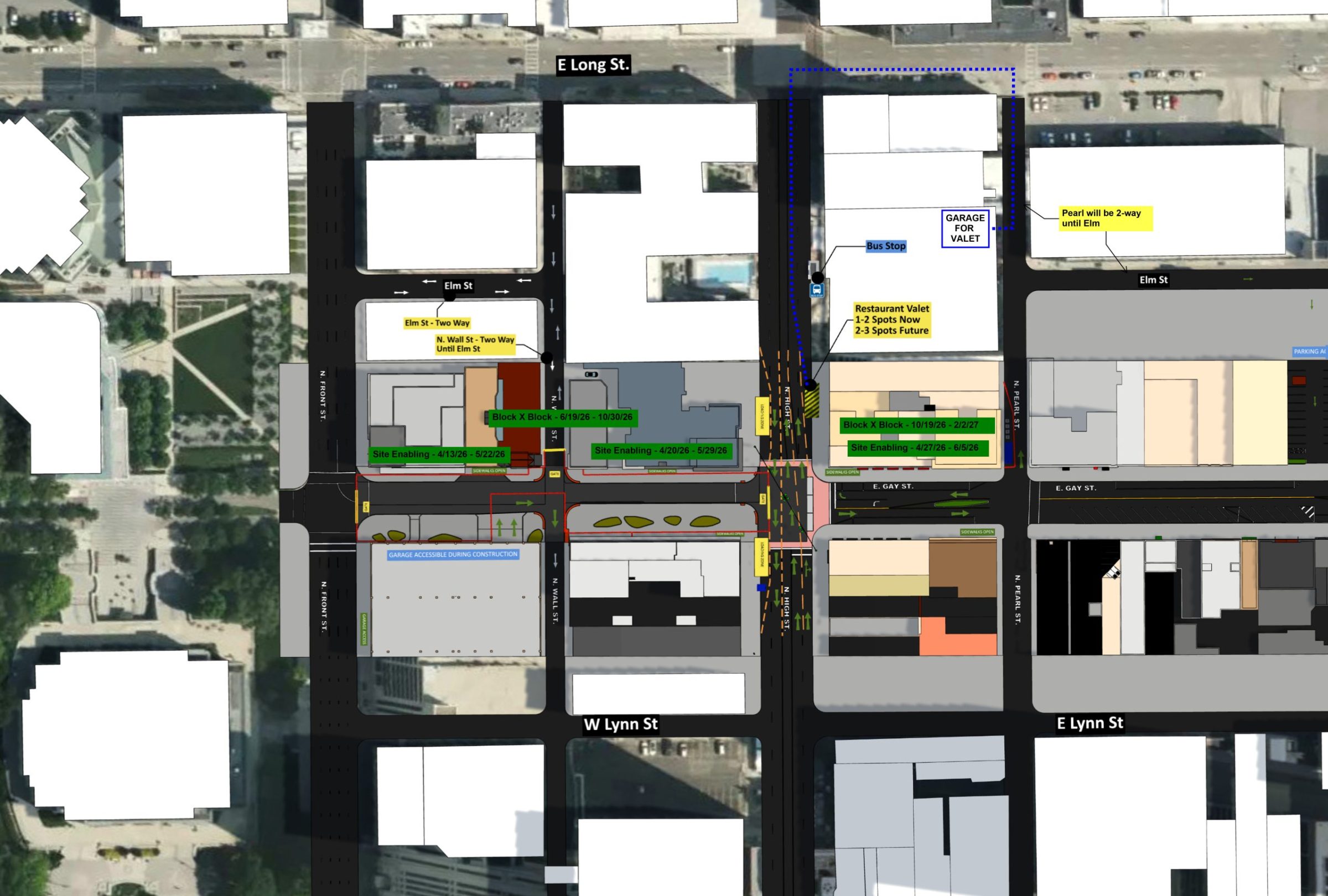

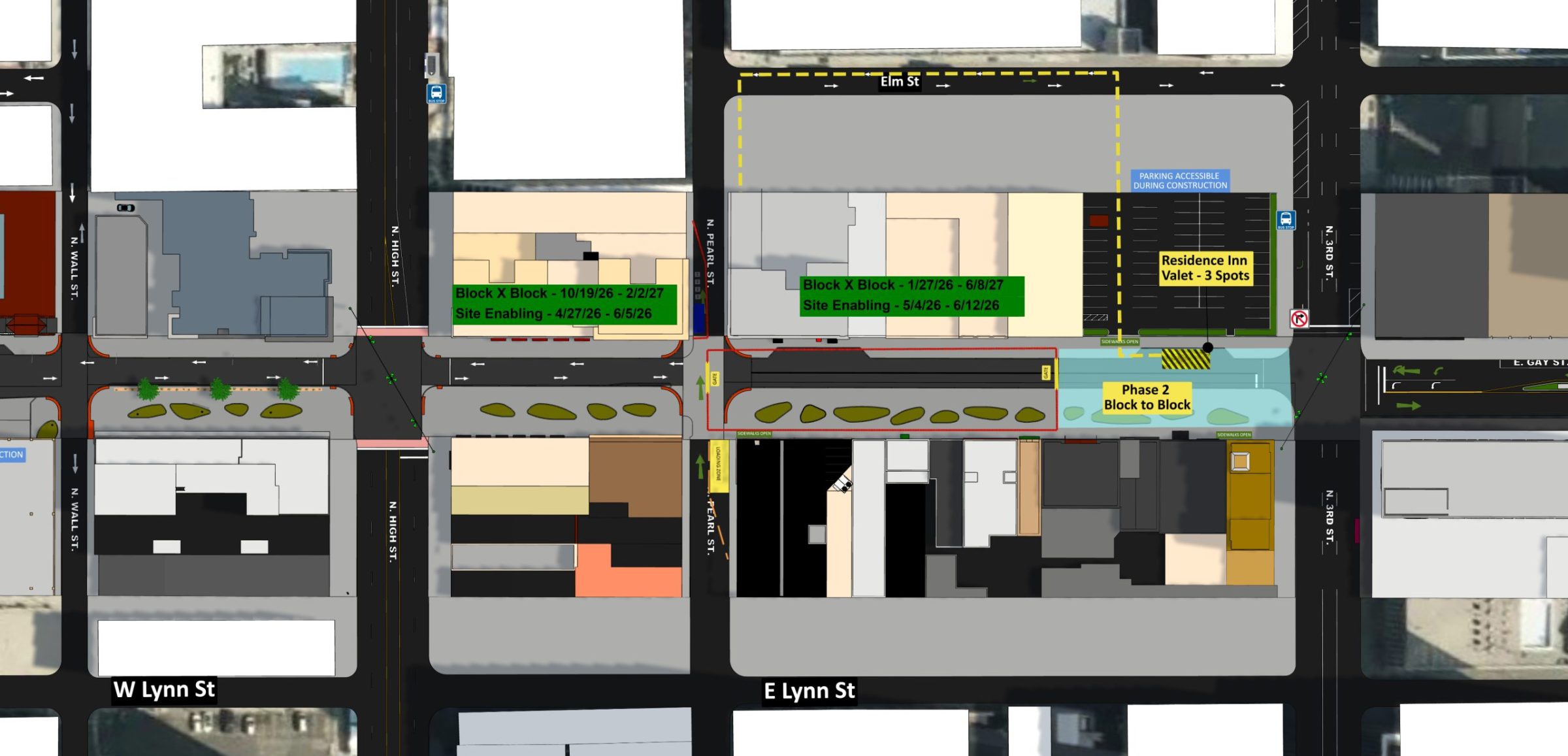

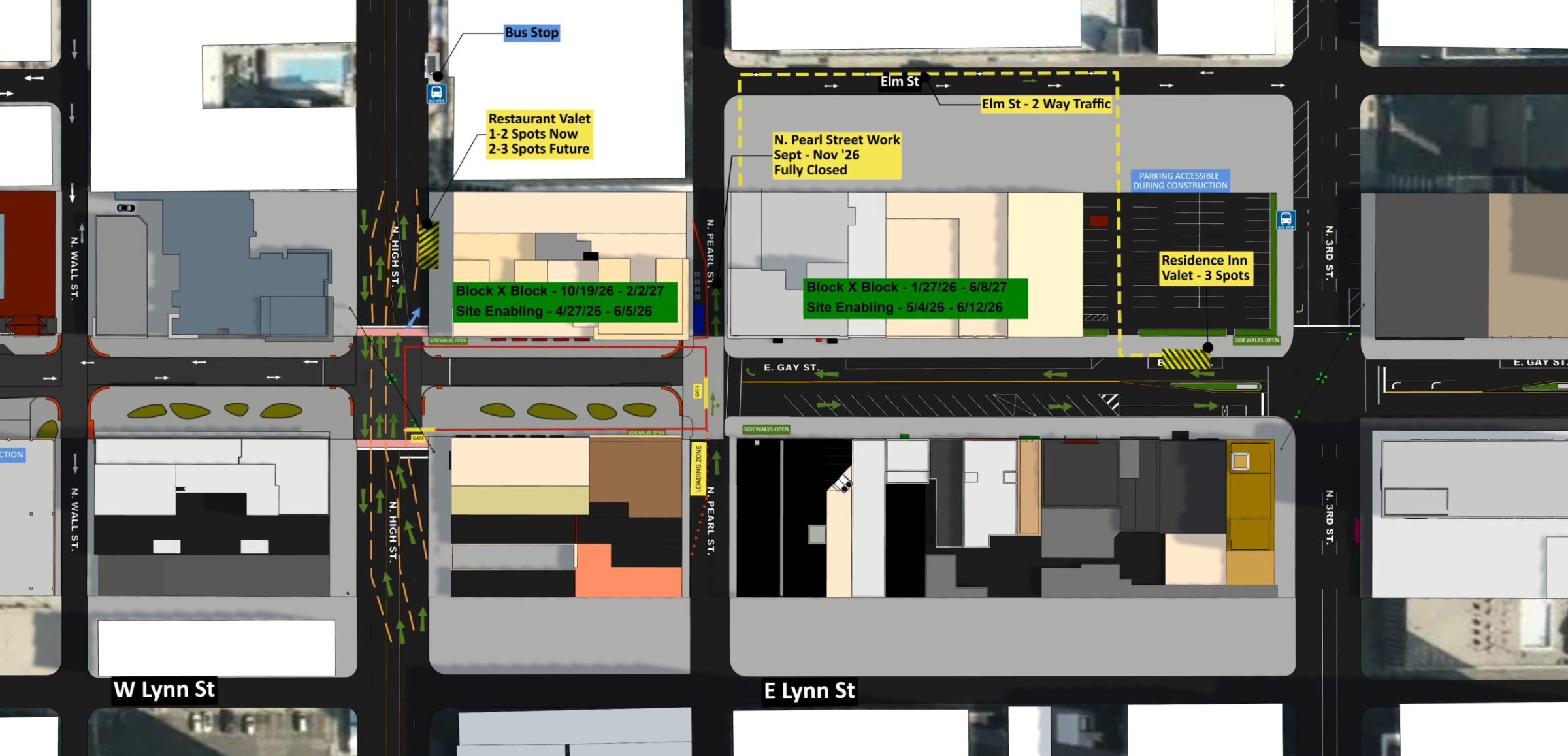

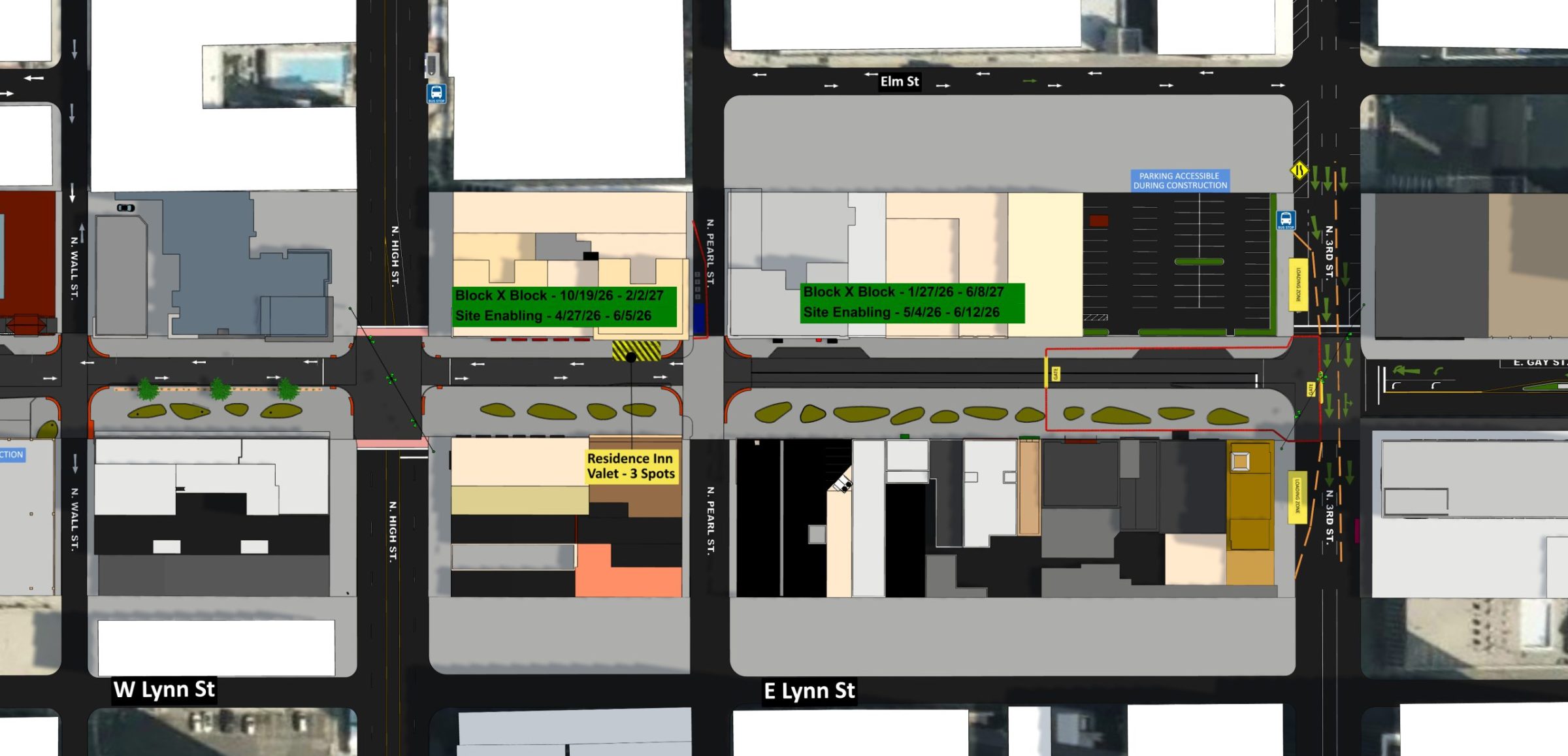

View block-to-block prep from Front to High: Phase 2A, Phase 2B

Step 3: Block-to-Block Construction

Road closed to vehicular traffic. Pedestrian access is maintained.

Once preparation work is complete, crews will begin full block-to-block reconstruction.

During this phase:

  • The active block will be closed to vehicular traffic. Loading zones will be identified.

  • Pedestrian access to buildings will be maintained.

  • Customers, employees, residents and visitors will use the newly constructed walkway adjacent to the building face for access.

  • Construction fencing will safely separate pedestrians from the active work zone.

  • Ramps and bridges will be used as needed to create accessible pathways through and around active construction.



Step 4: Intersections

As work moves east, the major intersections at High Street and Third Street will be reconstructed while work continues on the blocks on either side. Construction will occur one corner at a time, beginning at the southwest corner and moving clockwise around the intersection. Each corner is expected to take approximately two weeks, for a total construction duration of about two to three months per intersection.

Work at the alley intersections will be handled more flexibly to accommodate the many ways these alleys serve Gay Street businesses, including deliveries, loading, and access.



Traffic, Loading & Parking

After utility work is completed in October 2026, the areas of Gay Street outside the active construction block will reopen to two-way traffic.

As construction progresses east, completed sections of Gay Street will reopen while work continues on the next block.

To support access during construction:

  • Temporary loading zones will be available for deliveries, customer pickup and drop-off, rideshare services and quick stops.

  • Loading zones should generally be used for 15 minutes or less to keep them available for everyone.

  • Long-term on-street parking will not be available

  • The Fourth & Elm Garage validation program will continue for participating businesses.




New: Capital Line Office Hours

Have a question about construction? Want to talk through a concern specific to your business or property? We’re introducing Capital Line Office Hours to make it easier to connect with the project team in person.

Beginning Friday, July 17, a member of the Capital Line project team will be at Brioso Coffee every Wednesday and Friday from 9 – 10 a.m.

Stop by to:

  • Ask questions about upcoming construction
  • Review access, deliveries or construction impacts
  • Walk through issues on-site if needed

While we’re always available by phone or email, sometimes it’s easier to have a conversation face-to-face or step outside together to look at a specific concern. No appointment is necessary, just stop in during office hours.

  • Brioso Coffee
  • Wednesdays & Fridays, 9-10 a.m.

For your convenience, the location of office hours may change as construction progresses, so we’re always close to the active work area.



Need Immediate Assistance?

If you have an urgent construction issue or a concern that can’t wait until office hours, please don’t hesitate to contact us by phone or email. We’re happy to help or connect you with the appropriate member of the project team.

Project Updates & Business Support

Madison Cole, Capital Line Project Executive, Downtown Columbus, Inc.

760-409-7114 | [email protected]

Construction Questions & Onsite Issues

Alec Schroeder, Project Engineer

614-935-6093 | [email protected]

Jason Starr, Superintendent

740-485-1113 | [email protected]

Types of concerns they can help with quickly:

  • Dirt or materials on the building facade after excavation
  • Questions about work hours or durations in your immediate vicinity
  • Loading zone usage or related issues
  • Utility outage questions


Supporting Gay Street Businesses

We’re continuing to invest in tools that help customers find and support Gay Street businesses throughout construction.

As blocks close, construction fencing will feature Gay Street Awaits messaging, wayfinding and project renderings to help visitors navigate the corridor and get excited about the future. As work is completed, fencing will be removed as quickly as it is safe to do so, reopening portions of the street along the way.

Resources for Businesses:

Additional Promotion:

  • Sidewalk decals with QR codes

  • Third Street Billboard

  • Broad and High digital signage

  • Experience Columbus Visitor Guide Ad

  • A frame signage (coming soon)

Gay Street Construction Update: Preparing for the Next Phase
A look ahead at what’s happening with construction on Gay Street in the next two weeks.

Construction continues to make steady progress on Gay Street, and we’re preparing for the next major phase of work.

While utility work between High and Fourth Streets will continue through October, we’re also preparing to begin block-by-block construction from Front Street to High Street in August.

During this phase, the block will be closed to vehicular traffic, but pedestrian access to all buildings will be maintained at all times.

More details on the block-by-block schedule will be shared next week; below is a look at the work you’ll see over the next two weeks.



Here’s what you need to know this week:

  • No construction work will take place this weekend, but the UnderCurrent Bastille Day Festival will be happening this Sunday, July 12 from 1 – 4 pm in High Street from Gay to Long. High Street will be closed for this event.
  • Temporary utility shutdowns for vault properties will begin next week (July 13). Messer is reaching out directly to affected property owners at least two weeks in advance of planned shutdowns to coordinate.
  • Spectrum and Lumen shutdowns: Spectrum and Lumen customers will be temporarily without service Monday, July 27 through Thursday, July 30, only from 12 am-6 am each day to transition to new service lines. Customers should have received notifications directly. No other internet services will be disrupted due to Gay Street construction. If you are not a Spectrum or Lumen customer and experience internet issues, contact your provider directly.


A Look Ahead at Construction

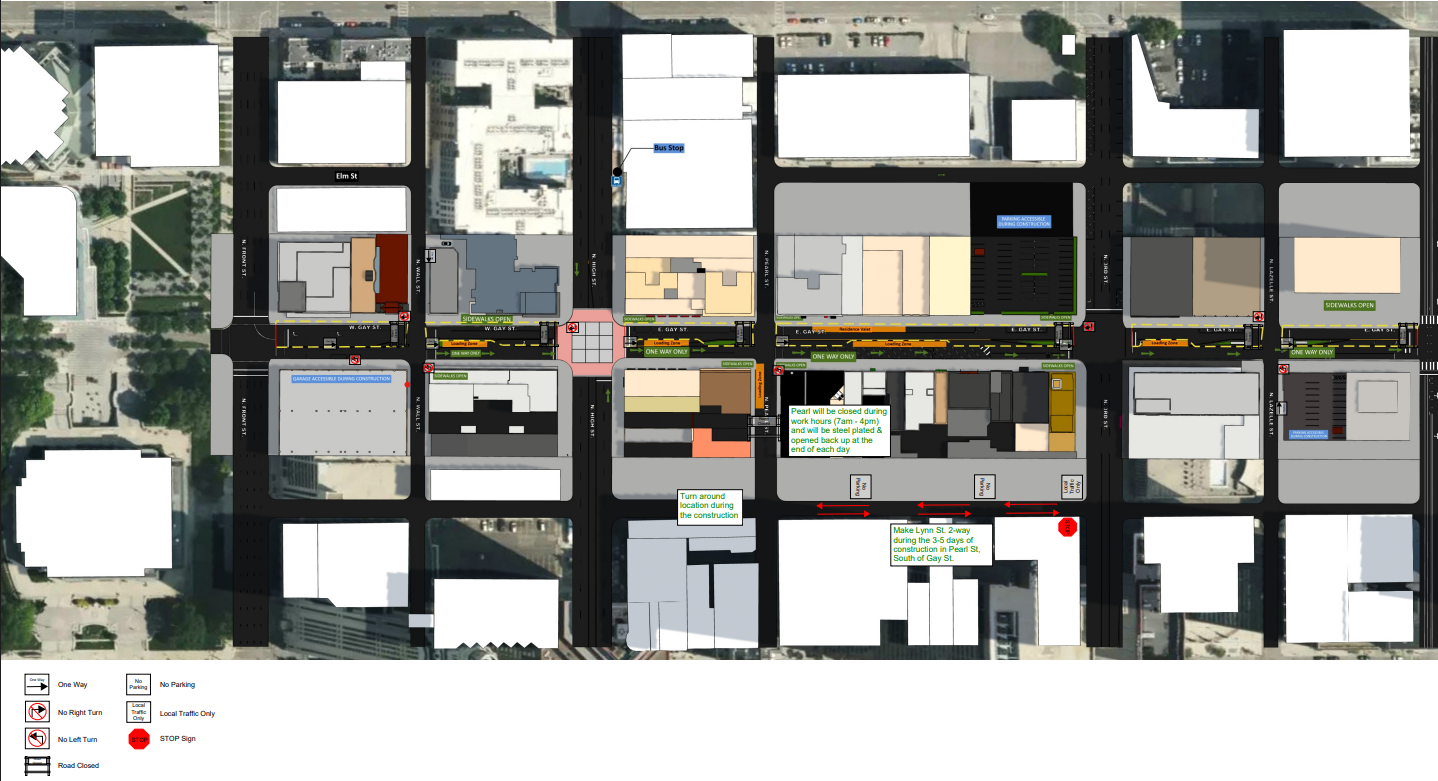

Front & Gay Intersection

  • Crews are currently working on the west side of Front Street at the Gay Street intersection on manholes, pedestrian ramps and laying pavers. Work will wrap up by Friday, July 24. Pedestrian crossing detours are signed.

Front Street to High Street: Preparation for Block-to-Block Work

Over the next month, crews will begin work directly in front of buildings, extending 6-12 feet from the building face. Here’s what you can expect:

  • Pedestrian access to all buildings will be maintained. Clearly marked pedestrian walkways and barricades will guide customers safely through the work zone.
  • Doorways will not be blocked. Messer will coordinate directly with each business to schedule work at the least disruptive time.
  • Temporary ramps may be installed to maintain access while new concrete is curing.
  • Construction noise will increase periodically as crews excavate along building frontages and install new storm structures throughout the street during normal work hours.
  • Once this phase is complete, a walkable temporary concrete sidewalk will be in place slightly below the final sidewalk elevation. Ramps will remain where needed to maintain accessibility until final sidewalk construction is complete.
High & Gay Intersection
  • Temporary traffic signals will be installed at High and Gay in late July.  These are only used during construction and won’t be part of the finished project.

High Street to Third Street
  • Waterline work will be completed by Friday, July 24. After a 30-day chlorination process, a temporary water shutdown will occur in late August. Affected property and business owners will be contacted directly as soon as we know when the City plans to complete the work (minimum two days’ notice).

Third & Gay Street Intersection
  • Third Street remains reduced to one southbound lane at the Gay Street intersection, Monday – Friday, 9am – 3pm until Friday, July 17.

Third Street to Fourth Street
  • Work to install the new duct bank between Third and Lazelle is expected to conclude by Friday, July 17.


Parking

If you need to request parking validations or would like to update the quantity you receive, please complete the form here for the next distribution.

For businesses who have parking validations, you can create a personalized map to direct parkers to your business using this Canva template. We’ve included copy below that you can share with customers through email, social media, text messages, your website, or any other communication channel. Copy and share this language:

Parking for Your Visit

Nearby parking is available in the 4th & Elm Garage for just $1 per hour for up to three hours with validation from us.

Here’s how it works:

  • Park in the 4th & Elm Garage and take your parking ticket.
  • Bring your ticket with you during your visit.
  • Ask for parking validation before you leave.



Marketing

We’re continuing to roll out new marketing and wayfinding tools to help visitors find and support Gay Street businesses during construction.

Here’s what’s new:

  • Billboard at Broad & High: A new digital display billboard is now up at one of Downtown’s busiest intersections, encouraging visitors to explore Gay Street, just one block away!
  • Sidewalk QR code stickers: New sidewalk decals featuring QR codes have also been installed throughout the corridor, making it easy for pedestrians to scan and discover nearby businesses, restaurants, events, and parking information.
  • A-frame signs coming soon: We heard your feedback that additional street-level wayfinding would be helpful. We’re actively working to add A-frame signs throughout the area to better direct pedestrians and inform them that Gay Street businesses remain open!
  • Construction fencing signage: As more fencing goes up in August, you’ll start to see new signage installed on construction fencing with wayfinding, project visuals and business promotion.
Help us spread the word: Don’t forget to take advantage of the Capital Line Construction Communications Toolkit and Canva template, which includes social media graphics, parking information, and other resources to let your customers know you’re open during construction.

We’re committed to keeping Gay Street visible, welcoming, and easy to navigate throughout construction.

Have questions about construction?
If you notice an issue that needs addressed on Gay Street, please feel free to reach out to the Messer Construction directly.

Alec Schroeder: 614-935-6093 | [email protected]
Jason Starr: 740-485-1113 | [email protected]

Types of concerns they can help with quickly:
  • Dirt or materials on the building facade after excavation
  • Questions about work hours or durations in your immediate vicinity
  • Loading zone usage or related issues
  • Utility outage questions


Gay Street Construction Update
A look ahead at what’s happening with construction on Gay Street in the next two weeks.

Thank you for your patience as work continues on Gay Street. Utility work between Front and High is wrapping up in preparation for block-by-block construction beginning in July.

At the same time, crews are shifting their focus to the Third Street area to install key water infrastructure and get the traffic duct bank in place, while vault work has advanced to the point where utility switchovers will begin mid-July.



Here’s what you need to know this week:

  • Work this Saturday, June 27: Hydrovacing will take place at the intersection of Gay & High from 8 a.m. to 3 p.m.

  • Overnight work the week of June 29: Crews will install temporary traffic signal poles and pull wires overnight at intersections along Gay Street. This work will have minimal impact and little to no noise, though you may notice crews working overnight.

  • Utility shutdowns for vault properties begin in mid-July: Planned overnight gas, and electrical service interruptions are required to transition utilities to the new infrastructure. We will coordinate directly with affected property owners and businesses. These outages apply only to properties with vaults.

  • Work expands near Third Street: Waterline and duct bank installation begins next week, bringing intermittent noise and temporary lane reductions on Third Street for the next month.

  • No work July 2–3: Construction will pause Thursday, July 2, and Friday, July 3, for the holiday weekend.



A Look Ahead at Construction

Gay & High Streets Intersection

  • Work will occur this Saturday, June 27, at the intersection of Gay & High from 8 am – 3 pm. There will be hydrovacing with intermittent noise.

Third & Gay Street Intersection

  • Starting the week of June 29, Third Street will be reduced to one southbound lane, Monday – Friday, 9 am – 3 pm for approximately 2-3 weeks.
  • Traffic will be maintained on the east side of the street, while the two west lanes will be closed.
  • This will involve intermittent hydro-vacuuming and saw cutting, which may create periods of increased noise. Work may also take place on Saturdays.

Third Street to Fourth Street

  • Work to install the new duct bank will occur between on the south side of Gay Street between Third and Lazelle Street from 7 am – 3:30 pm for approx. one month starting the week of June 29.



As vault work continues, AEP and Columbia Gas will be conducting shutdowns to transfer services to updated systems. Overnight shutdowns are tentatively planned to take place from July 15 through August 8. We will be reaching out directly to affected property owners and businesses to coordinate shut downs. This applies only to properties with a vault being modified (22, 47, 51, 59, 71-73, 75-81 E Gay)

Thank you for your continued patience as work progresses on Gay Street. We know construction can be disruptive, and we truly appreciate your flexibility as crews work to improve the corridor.

As work continues, the team has encountered a few unforeseen underground conditions that have required more hydro excavation than originally anticipated, but the project is still on schedule.

Please note that no construction work is planned for Thursday, July 2, or Friday, July 3.

Work Activity This Saturday, June 13

Crews will be working this Saturday, June 13, from 7 a.m. to 4 p.m., with hydro excavation beginning at 8 a.m.

Work will take place at the southeast corner of Gay and Wall Streets, along the sidewalk near Veritas, and at the southwest corner of the Gay and High Street intersection.

Water Line Shutdown Planned for Wednesday, June 17, at 10 p.m.

To complete the transition to the new water main, the City of Columbus will conduct a temporary water service shutdown beginning at 10 p.m. on Wednesday, June 17. The shutdown is expected to last approximately 2–4 hours.

During the shutdown, water service will be unavailable. Sinks, toilets, and water-dependent appliances will not be operational until service is restored, which is currently anticipated around 2 a.m.

We are still working with the City of Columbus to confirm the exact buildings that will be affected, but impacts are expected to be limited primarily to properties between Front Street and High Street. As soon as we have confirmation, we will notify impacted buildings directly.

Affected properties will also receive a door notice from Complete General Construction with additional details.

Interconnect Duct Bank Splicing Scheduled for June 19–21

Beginning Friday, June 19, and continuing through Sunday, June 21, crews will be working near the intersection of Gay and Wall Streets to complete more than 2,500 fiber splices connecting the duct bank between Front Street and High Street.

Work is expected to occur during the following times:

  • Friday, June 19, 7 p.m. – Saturday, June 20, 7 a.m.
  • Saturday, June 20, 4 p.m. – Sunday, June 21, 9 a.m.



Please note that High Street will be closed for the Stonewall Columbus Pride March on Saturday, June 20, from 9 a.m. to 2 p.m.

You may notice a work truck, generator, and temporary lighting in the area during this work. No additional road closures or traffic restrictions are anticipated.

A Look Ahead

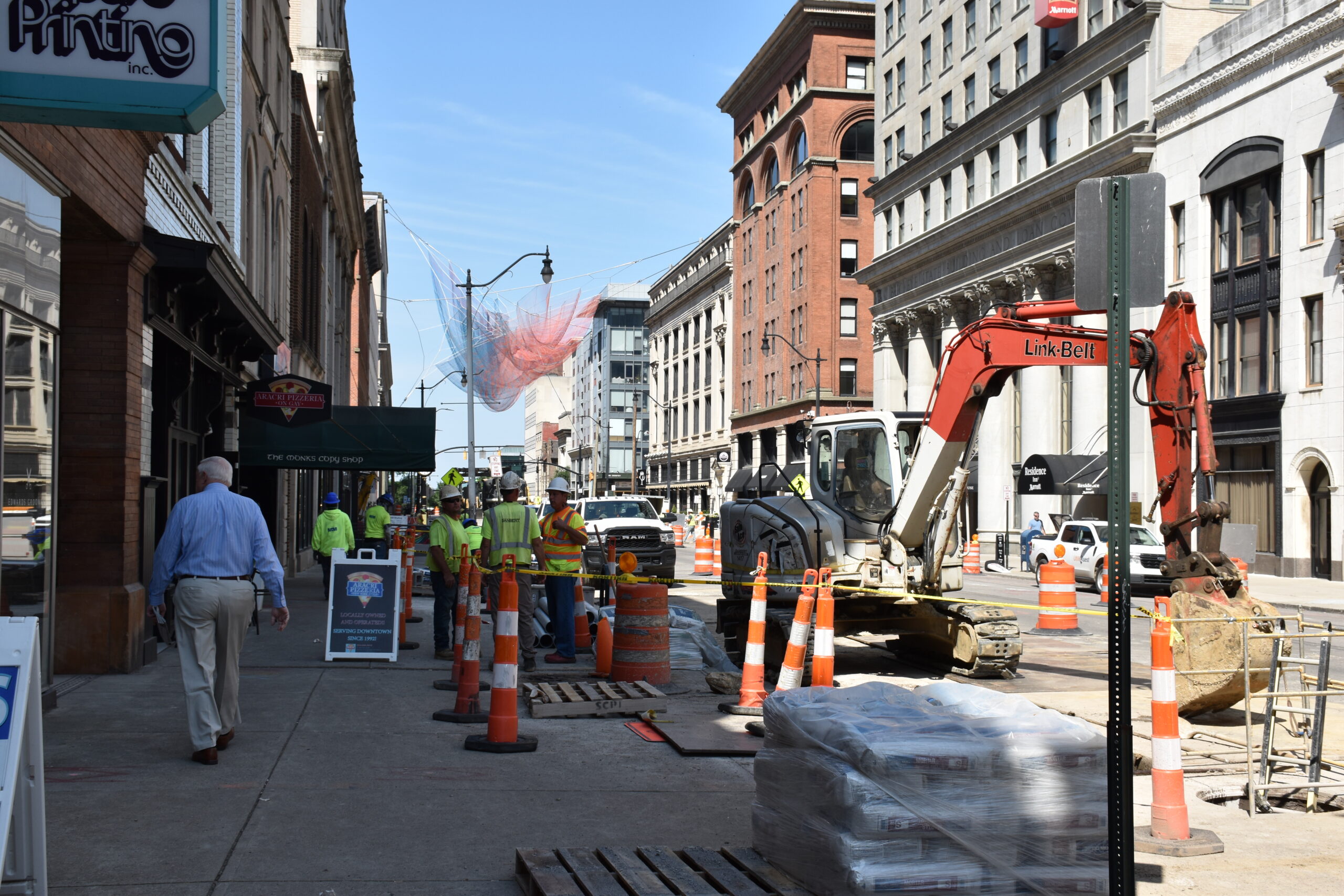

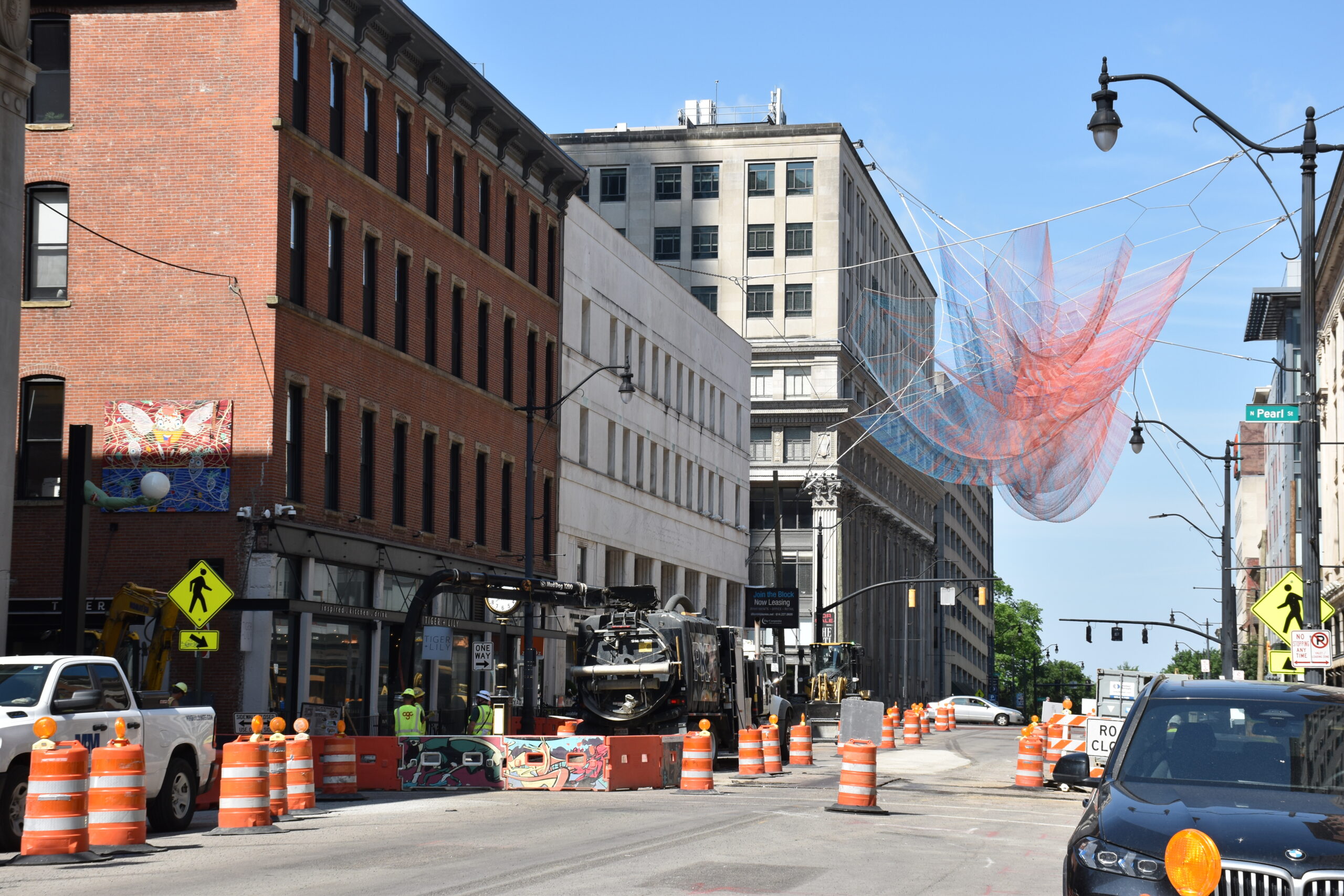

Front Street to High Street

  • Hydro excavation near Gay and Wall Streets (Veritas) and on High Street will continue through Tuesday, June 16.
  • The water service shutdown is scheduled for Wednesday, June 17, at 10 p.m. and is expected to last 2–4 hours.



High Street to Pearl Street

  • A new water service line will be installed for the building at the northeast corner of Gay and High Streets (near Chouette) from June 15–17. This work will involve intermittent elevated noise levels.
  • Beginning around June 17, private utility work will cross High Street into this block. Several days of excavation and hydro excavation are expected.



Pearl Street to Third Street

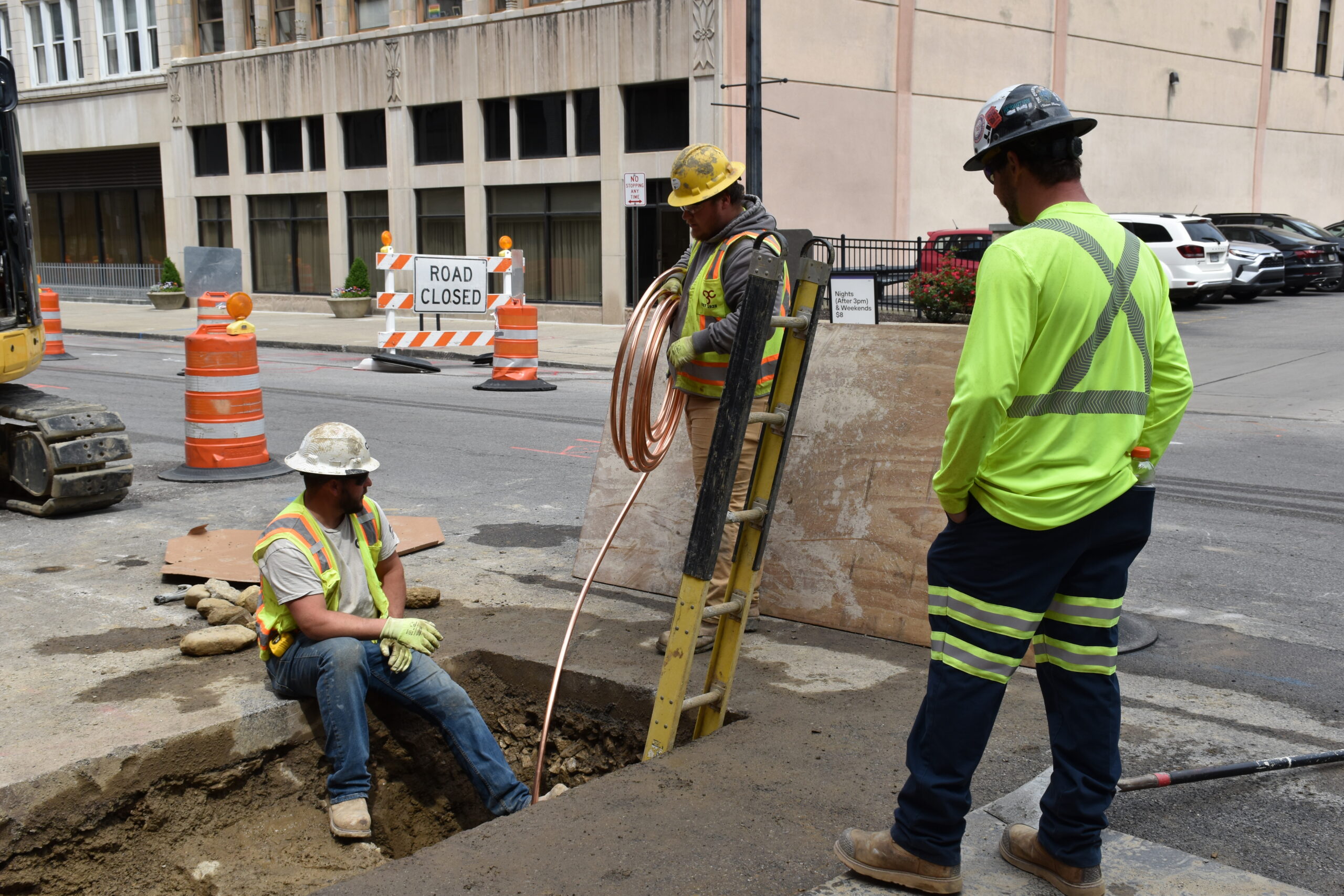

  • Water line work will continue into early next week, including intermittent hydro excavation activities.



Third Street to Fourth Street

  • Starting June 22, hydro excavation will take place in one lane of Third Street during daytime hours (approximately 9 a.m. to 3 p.m.) for about two weeks. Third Street will be reduced to two southbound lanes during this work. Left turns from Third Street onto Gay Street will be maintained.
  • Saw cutting for the duct bank and additional hydro excavation for the water line will begin the week of June 29.
  • Beginning July 6, work is expected to move to the corner of Gay and Lazelle Streets.



Parking

To help make visiting Gay Street businesses easier during construction, customers can park at the Fourth & Elm Garage for just $1 per hour for up to three hours with validation from a participating Gay Street business.

Businesses interested in receiving monthly parking validations can complete the attached form.

Please feel free to share this video or use the graphic to spread the word to your customers about this option.

Work to prepare the underground infrastructure is continuing. Here’s a closer look at some of the work you may see happening on the street.

Overall

You can expect periodic hydro excavation and jackhammering during work hours (Monday–Friday, 7:00 a.m.–3:30 p.m.) through the end of June. Saw cutting will begin at Gay and Front Streets the week of May 18 and progress east through the corridor.

Pearl Alley

This week, excavation work will begin in Pearl Street for the next 1–2 weeks. During this work, South Pearl Street will be closed to vehicular traffic during work hours but will remain open to pedestrians. South Pearl Street will reopen for vehicles at 4 p.m. each day.

Lynn Alley will remain open to two-way local traffic.

North Pearl Alley will remain closed to vehicular traffic.

Click here to see a map with this traffic flow.

Vault Water Line Work

Over the next month, water line work associated with the vaults will also take place along Gay Street. As crews are available, they will set up small barrier areas that may block part of the sidewalk and, in some cases, extend to the building face.

In these areas, pedestrians may be directed to use an alternate path, but access to building entrances will be maintained. Each location is expected to take approximately 2–3 days to complete. If your property has a vault, Messer will contact the property owner 1–2 days in advance to provide notice of the work.

There are no planned water outages at this time.

We’re moving full steam ahead with utility enablement construction on Gay Street beginning Monday, April 20.

If you missed our last update covering new traffic patterns, demolition and parking validation details, access it here.

Reminder: Gay Street on-street parking will be removed on Monday, April 20 from Front to Fourth Street.

If you requested parking validations for the Fourth and Elm Garage, a Safer Downtown ambassador will deliver those by Friday, April 17.

Missed the window to request validations? Submit a request here and we’ll do our best to get those to you quickly.

If you’re looking for resources to keep customers and employees up to date throughout construction, use the toolkit materials available here. There’s also an editable Canva template accessible here.

 LOADING AND DELIVERY ZONES

During the first phase of construction (April–June) use the designated loading zones found in the image below for day-to-day needs including:

  • Deliveries
  • Customer drop-off and pick-up (rideshare, taxis, etc.)
  • Carryout and delivery order pick-up

Please note: these zones are not for short- or long-term parking.

Good afternoon,

Construction will begin on Gay Street on Monday, April 20. Here’s what to expect in the first two weeks.

Week of April 20

Crews will begin removing medians, trees, on-street parking and parking payment kiosks along Gay Street from Front Street to Fourth Street.

  1. Work will occur during typical daytime hours (7 am – 3:30 pm).
  1. Gay Street will be reduced to one lane, one-way eastbound, using barrels to maintain traffic.
  1. Pedestrian access to all businesses will be maintained at all times.

Beginning April 20, on-street parking on Gay Street from Front Street to Fourth Street will be removed for the duration of construction. Convenient and affordable parking will be available at the 4th and Elm Garage ($1 per hour, 3 hours max). See details below to request validations for your business.

Week of April 27

Utility enablement work will begin on the Front Street to High Street block, moving east to Fourth Street. This phase is expected to last approximately six weeks.

  1. Gay Street will remain one lane, one-way eastbound (Front to Fourth) during this work.
  1. During this phase, you will notice temporary traffic signals going up at High Street, Third Street and Fourth Street to help direct traffic. These will only be part of construction, not the finished project.
  1. The work will primarily take place on the north side of the street. The sidewalk will not be impacted.
  1. This work involves crews digging into and beneath the street. Jack hammering and hydro-excavation will occur periodically, resulting in intermittent increased noise during typical hours (7 a.m.–3:30 p.m.)

Huntington SBA Loan

Make upgrades to your business during construction with the Huntington SBA loan. Huntington will waive Huntington origination and SBA guarantee fees when you open a SBA Loan up to $350,000. Enjoy a one-year draw and a 9-year repayment at 6% interest. Contact Austin Huff at [email protected] for more information.

Business Support

Resources to keep your customers and employees up to date through construction.

Employee Parking

Employee parking for service businesses is also available for $60 per month at this garage.

Questions about The Capital Line:

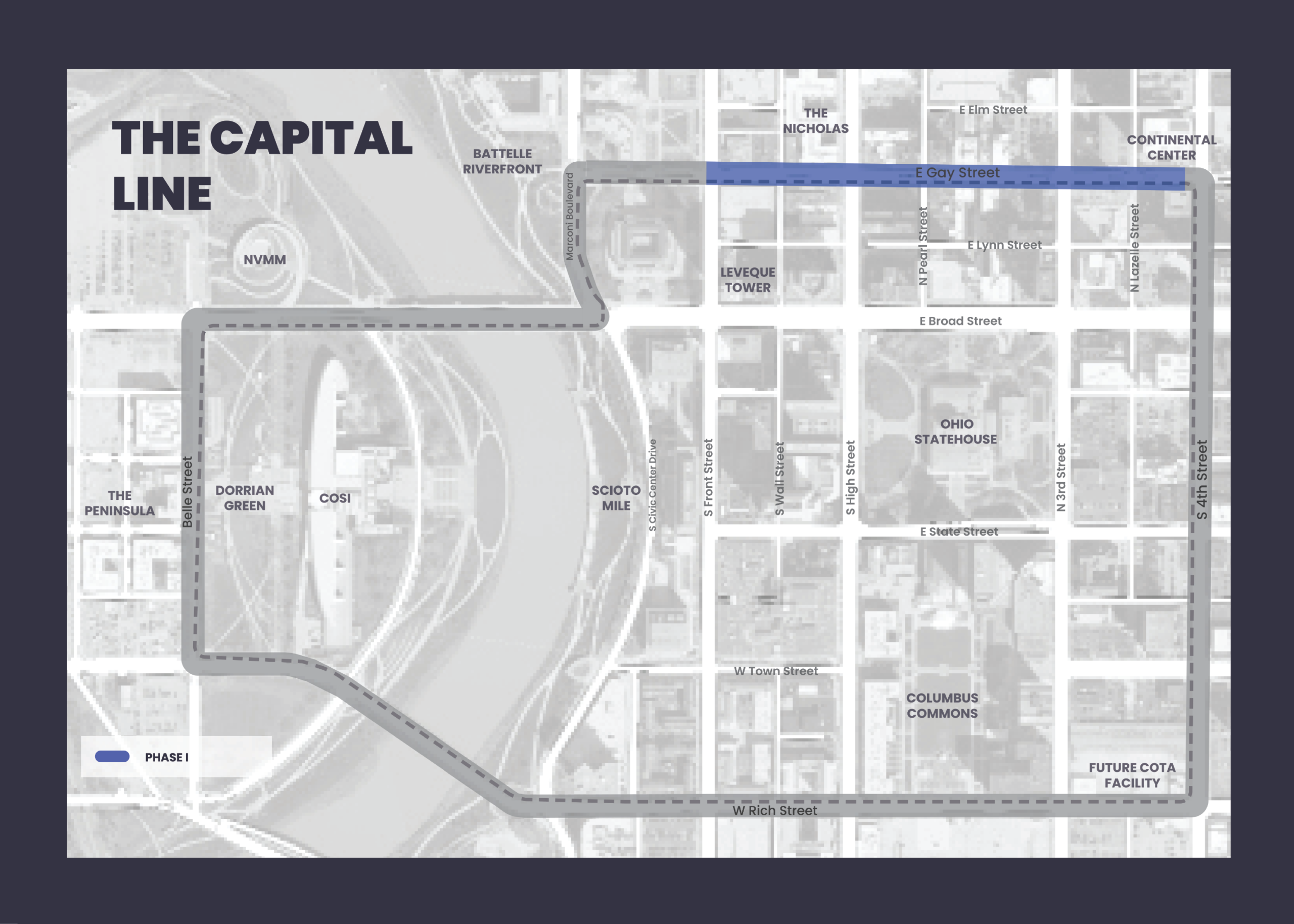

The Capital Line is an urban pathway through the heart of Downtown Columbus. This two-mile journey, exclusive to bike and pedestrian traffic, offers an intentional route to some of the city’s most vibrant attractions, connecting amenities, greenspaces, job centers, and residential neighborhoods within Downtown Columbus, catalyzing new economic investment along the route and enhancing the Downtown experience to put people first.

The Capital Line will directly further the goals of the community to create a connected Downtown that puts people first, supports business growth, increases livability and inclusivity, and enhances the Downtown experience.

This idea came from the community through the 2022 Downtown Strategic Plan. We heard about the desire for connection to assets that have already been built. We heard that protected bike paths are vital as we grow as a city. We heard that the journey is just as important as the destination.

The Capital Line combines some of these best ideas. Connecting assets already in place. Providing alternative means to get around Downtown. Making the journey enjoyable and intentional. Creating economic development opportunities in the heart of our Downtown.

We’ve seen other cities do this – from the Cultural Trail in Indianapolis, which generated $1 billion in economic impact along the trail, to the High Line in New York and the Beltline in Atlanta. All of them have an economic impact story to tell.  National precedents for this type of infrastructure investment also demonstrate a significant ROI for communities that create them – an average of $27 returned for every $1 invested.

We’re too early in the process to pinpoint an exact total, but estimates based on similar projects, such as the Indianapolis Cultural Trail, The Underline in Miami and the Atlanta Beltline, suggest an approximate cost of $100 million for the full two-mile path. Funding will come from both private and public sources, as well as philanthropic investments. Current funders include the State of Ohio, the City of Columbus, and the Columbus Foundation.

This construction will occur in phases. The initial phase will begin as part of a reimagination of Gay Street, with design occurring in 2024 and construction beginning in late 2025. Future phases will follow a similar timeframe, with completion of the 2-mile loop in 2028. Construction manager, Messer Construction, is currently designing the full construction schedule.

While design elements are not yet finalized, the Capital Line will have specific pavers, landscaping, street furniture and other elements that will help distinguish it. For specific design elements, take a look at the most recent deck presented at the June 4 community meeting, linked at the top of this page.

The Capital Line is going to do what’s worked for Downtown Columbus for more than a decade, creating places for the community by reimagining underutilized space – from vacant department stores and malls to surface parking lots. Now we have our sights set on the overly wide urban streets.

By repurposing part of the existing right of way, the benefits are two-fold. First, adding a safe protected space for pedestrians and bikers within the streetscape, prioritizing the ideal primary user of Downtown streets – people. Secondly, narrowing too-large streets to calm traffic in key corridors.

It’s not a reduction, it’s a rightsizing. Downtown has evolved over the past decade from an employment center to an experience center. Workers join a growing residential and visitor population, and rethinking how our underutilized public rights-of-way can be put to work for pedestrians will make Downtown more resilient.

Sign up for our update email list at the top of this webpage and keep an eye out for upcoming public meetings.

Project Lead

Project Funders

Phase I Project Team
